CNC Machining Lead Time from Vietnam — What’s Actually Realistic in 2026
cnc machining lead time vietnam
Every Vietnam CNC supplier quotes “7–12 business days.” What that number actually covers — and what it doesn’t — determines whether your production schedule holds or slips by three weeks.
This guide addresses the real CNC machining lead time from Vietnam — not the marketing number, but the full order-to-delivery pipeline: what each phase includes, where delays actually originate, when expedited service is worth the premium, and how to build a realistic procurement calendar that accounts for every stage.
Numbers below reflect standard CNC machining orders shipped from Ho Chi Minh City. Lead times for injection molding, sheet metal, and tooling follow different cycles and are noted separately where relevant.
What Vietnam CNC Machining Lead Time Actually Includes (and Doesn’t)
The 7–12 day window quoted by most Vietnam CNC suppliers refers to machining production time only — the period from confirmed drawings to parts-ready-for-inspection. It does not include:
Drawing review and DFM: If your CAD files have unresolvable tolerances, missing material callouts, or features that require EDM, a DFM round adds 1–3 business days before production starts. Well-prepared STEP/DXF files with full GD&T callouts eliminate this entirely.
Material procurement: Standard aluminum 6061-T6 and 304 stainless are stocked. Specialty alloys — 7075-T6, 17-4 PH, Ti-6Al-4V, tool steel — require procurement if not in stock. Add 2–5 days depending on local supply.
Surface finishing: Anodize Type II/III, passivation, electroless nickel, and hard chrome are performed post-machining. Most finishing processes add 1–3 days. Black oxide and bead blast are same-day.
Final inspection and CMM reporting: Every order at VNcontX ships with a 100% FAI and CMM report (Zeiss Contura or Mitutoyo). This is included in lead time, not added on top, but it is part of what the 7–12 days covers.
The practical implication: quote yourself 12–16 business days from drawing approval to parts at the forwarder for a standard order with finishing. Precision parts with tight GD&T and specialty material run 14–18 days.
The Full Timeline: Drawing Approval to Parts at Your Dock
Supplier reviews STEP/DXF, flags unmachinable features, confirms tolerances and material. Well-prepared files pass in 24 hours. Complex assemblies or first-time geometries may require one round of comments. Clock starts when you receive written DFM approval — not when you send the files.
Standard stock: Al 6061-T6, 1018 steel, 304/316 SS — typically same-day. Non-stocked: 7075, Ti-6Al-4V, 17-4 PH, PEEK — 2–5 days from local distributors in HCMC. Imported specialty materials (NAK80, S136 tool steel) can add 5–10 days and should be confirmed before order placement.

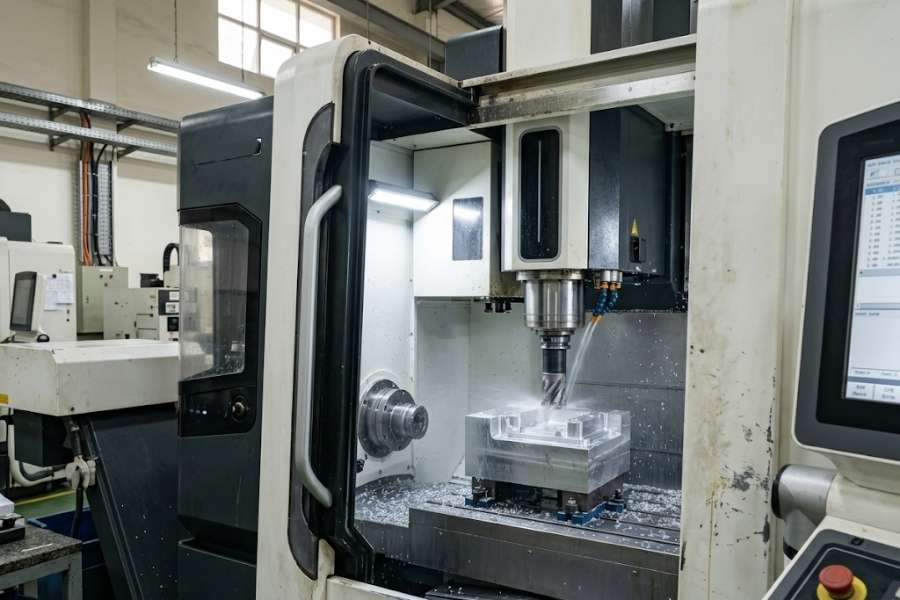

3-axis, 4-axis, and 5-axis milling on DMG Mori. Turning on Mazak QT. Parts requiring both milling and turning (mill-turn) are completed in-house without subcontracting. In-process inspection occurs at each operation. This is the phase suppliers quote — all other phases are additional.
Bead blast and black oxide: same-day. Anodize Type II/III (MIL-A-8625F): 1–2 days. Passivation, electroless nickel, hard chrome: 2–3 days via qualified subcontractors in Bình Chánh District. All finishing is coordinated by VNcontX — you receive a single shipment.

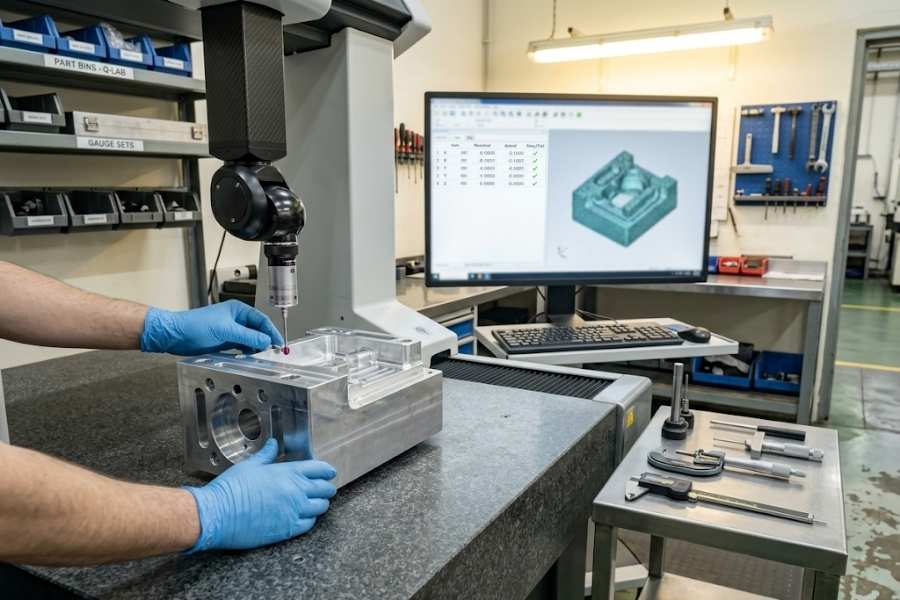

100% First Article Inspection on every order. Zeiss Contura CMM for critical dimensions. Mitutoyo for standard features. Full dimensional report issued before shipment — not a sample check. Cpk ≥ 1.67 required for production release. Reports are emailed with the shipping notification.
Parts are packed per customer spec (ESD, VCI, foam-in-place). Export documentation prepared: commercial invoice, packing list, Certificate of Origin Form D (AANZFTA) or EUR.1 (EVFTA), MSDS where applicable. Cat Lai Port is 25km from the facility. Tan Son Nhat Airport for air freight.
Air freight ex-SGN direct to LAX, SYD, FRA, or connecting via SIN. Sea freight FCL/LCL ex-Cat Lai Port via Evergreen, Maersk, and CMA CGM to US, AU, EU ports. Customs clearance at destination: typically 1–3 days air, 2–5 days sea depending on broker and HS code.
What Causes Delays — and How Frequently
In a five-year production sample, the delay sources below account for roughly 95% of all late shipments. The other 5% is force majeure — carrier disruptions, customs holds, typhoon season (July–October).
Incomplete or Ambiguous Drawings
Missing tolerances on critical fits, conflicting dimensions between drawing views, no material or finish callout. Each DFM round costs 24–48 hours. Providing a fully dimensioned STEP file with a 2D drawing for GD&T callouts eliminates this.
Non-Stocked Material Requirement
Ti-6Al-4V, PEEK, 17-4 PH, and specialty tool steels are not warehouse stock. If you need these, confirm availability at RFQ stage. Procurement typically adds 3–5 days; some alloys require import and can add 10+.
Finishing Subcontractor Queue
Hard chrome and electroless nickel subcontractors run batch cycles. During peak periods (Q4, pre-Tet), queue time can extend by 2–4 days. Communicating finish requirements at order placement allows scheduling coordination.
First Article Rejection
If CMM report shows out-of-tolerance features, the batch is held and reworked before shipment. This is uncommon (VNcontX OTD 98.4%) but adds 1–3 days when it occurs. Root cause is almost always tolerance stack-up in multi-part assemblies.
Expedited vs Standard: When the CNC Machining Turnaround Time Premium Is Worth It
Expedited CNC machining (5–7 days) at VNcontX carries a 20–35% surcharge on machining cost. Whether that premium makes sense depends on three variables: your inventory buffer, the unit cost of the part, and what the delay actually costs downstream.
Expedited is clearly worth it when: you are resupplying a production line that stops without the part. The downstream cost per day (line downtime, contractor idle time, delayed shipment penalties) exceeds the premium. The part is low unit-cost — a 30% surcharge on a $12 machined component is $3.60, which is negligible against a $500/day line stoppage.
Expedited is rarely worth it when: the delay is in transit, not production. Air freight costs on a 50kg shipment from HCMC to LAX run $400–600 — often 3–5× the machining premium. If your production schedule has a three-week runway, standard production with air freight is frequently faster door-to-door than expedited production with sea freight.
For prototyping, expedited production with air freight (total 7–10 days dock-to-dock) is the standard choice. For production volume, sea freight with a 4-week total pipeline and a 2-week safety buffer outperforms expedited on cost without meaningful schedule risk.
Air vs Sea: The Real Trade-off by Order Profile
| Factor | Air Freight (SGN → LAX) | Sea Freight (Cat Lai → LA/LB) |
|---|---|---|
| Transit time | 2–3 days | 18–22 days |
| Cost per kg | $8–14 USD | $0.80–1.40 USD |
| Break-even weight | Air viable under ~50kg or when part value > $5,000. Sea for repeat production runs. | |
| Customs risk | Low (1–2 day clearance) | Low–Medium (2–5 days, occasional hold) |
| Best for | Prototypes, samples, urgent resupply, high-value precision components | Production runs, heavy parts, cost-sensitive orders, repeat orders |
For Australian buyers: air freight SGN → SYD runs 3–4 days. Sea freight via Singapore or direct to Melbourne/Sydney runs 12–16 days — significantly shorter than US routes. This makes sea freight more competitive for AU procurement cycles.
How to Build a Realistic Vietnam Production Lead Time Calendar
Working backward from your required dock date, apply the following buffer framework for a standard CNC order with surface finishing via sea freight to US West Coast:
Required dock date (Day 0)
→ Subtract 3 days customs clearance: Day −3
→ Subtract 22 days sea transit: Day −25
→ Subtract 2 days export prep and forwarder: Day −27
→ Subtract 1 day final inspection: Day −28
→ Subtract 2 days finishing: Day −30
→ Subtract 12 days machining (standard): Day −42
→ Subtract 3 days material (if non-stocked): Day −45
→ Subtract 2 days DFM review: Day −47
This gives you a 47 calendar-day total pipeline for a standard order with specialty material and surface finishing — sea freight to US West Coast. For well-prepared drawings, stocked material, and no finishing, this compresses to 32 days.
For repeat orders where toolpaths, materials, and inspection plans are already established, production lead time drops to 5–7 days. Building a repeat-order relationship with a fixed monthly release schedule is the most reliable way to maintain a short effective lead time without paying expedite premiums.
Communication Protocol: How to Stay Updated Without Micromanaging
Effective production communication reduces delays without adding overhead to either party. The following protocol works for standard CNC orders from Vietnam:
At order placement: Confirm the complete scope in writing — material grade, finish specification, packaging, export documentation requirements, and named forwarder if you have one. Ambiguity at this stage is the single largest source of avoidable delays.
After DFM approval: Request a written production start date and scheduled completion date. This is the reference point for all subsequent status checks — not the initial quoted lead time, which is a general range.
Mid-production check-in: One update at the halfway point of production is sufficient for standard orders. Request in-process photos if you want visual confirmation of setups. Zeiss CMM in-process data is available on request for critical dimensions.
Pre-shipment: CMM report and packing photos sent before the forwarder hand-off. This is the point to flag any dimensional queries — not after the shipment arrives.
Shipping notification: Tracking number, AWB or B/L, and full export documentation set. For US importers, confirm the Schedule B/HTS code and country of origin at this stage to accelerate customs clearance.
Frequently Asked Questions
Plan Your Production Timeline with VNcontX
Send your drawings. We’ll confirm material availability, DFM status, and a firm production schedule — within 24 hours on business days.
Request a Technical Quote → Talk to an Engineer →
